VGF Scheme for development of BESS through Power System Development Fund

9th June 2025

Considering the requirement of Energy Storage in the country, Minister of Power announced provision of Viability Gap Funding to 15 number of States and NTPC at Rs. 18 Lakhs per MWh for development of 30 GWh BESS capacity supported through PSDF

amounts to total financial support of Rs. 5,400 Crores from PSDF

This allocation includes 25 GWh of BESS capacity allocated to 15 States to facilitate them in meeting their Energy Storage System requirements. In addition, 5 GWh of BESS capacity is allocated to NTPC, which is to be developed for optimum utilization of existing thermal generation and transmission infrastructure as well as to facilitate meeting non-solar hour electricity demand in a reliable and economic manner

All the concerned States and NTPC are required to submit proposal to NLDC, the nodal agency for PSDF, as per the extant Guidelines /Procedure for funding of the projects under PSDF, within 30 days from the date of issuance of this letter

We capture summary of guidelines for VGF Funding

Advertisement Space — Coming Soon

Objective

Development of 30GWh BESS capacity for deployment to ensure grid integration of RE and reliable electricity supply

Energy storage systems are essential for integration of variable renewable energy (vRE) sources in the electricity grid. With an installation target of 393 GW (293 GW Solar and 100 GW Wind) by 2030, vRE will constitute approx. 50% of the installed generation capacity by 2030

Increasing share of RE also necessitate flexible operation of thermal generation plants. The variability of renewable generation requires thermal generators to back down during periods of high RE availability, especially during solar hours. However, during evening peak hours, when solar generation is not available, thermal plants are essential to meet the evening peak. Therefore, BESS may also be installed with thermal power stations to leverage existing generation and transmission infrastructure efficiently

As per CEA, 37GWh BESS capacity is required by 2027 and the requirement will increase to 236 GWh by 2031-32. BESS capacity of 13.2 GWh has been approved under the ongoing VGF scheme for development of BESS

Advertisement Space — Coming Soon

Scheme Overview

Viability Gap Funding (VGF): VGF of Rs 18 lakh per MWh, shall be provided and is aimed at supporting a BESS capacity of 30 GWh.

Scheme Budget: This scheme has a budgetary allocation of Rs 5,400 Crore. The VGF shall be a non-recurring expenditure and shall be fully funded from Power System Development Fund (PSDF). The disbursement of funds shall be as per procedure applicable for PSDF. The VGF for each project shall be disbursed to the Eligible Entity/ REIΑ, once CEA certifies the achievement of the disbursement schedule milestone and submission of the required Bank Guarantee

Commissioning Period: The projects are required to be commissioned within a period of 18 months from the date of signing of Battery Energy Storage Purchase Agreement (BESPA) / Power Purchase Agreement (PPA)

Eligible Entities: State utilities or agencies authorized by States Governments or Central Government shall be eligible

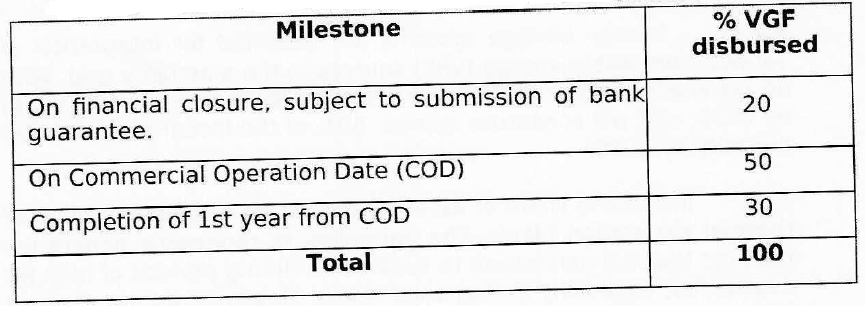

Disbursement schedule: The VGF amount to the eligible projects shall be disbursed in three tranches as detailed below:


Storage Duration: The BESS capacity should preferably be with 2-hour discharge duration and average 1.5 cycles in a day i.e within 24 Hour period. However, the Eligible Entity may vary the duration, no of cycles as required

Advertisement Space — Coming Soon

Implementaion Model

Bidding Process: BESS projects shall be awarded using the Tariff Based Competitive Bidding (TBCB) process under section 63 of the Electricity Act, 2003

Contract Period: The contract period shall be specified in the RfS document, in accordance with the BESS TBCB Guidelines. The contract shall be awarded on Build Own Operate (BOO)/ Build Own Operate Transfer (BOOT) basis preferably for a contract period of 12 to 15 years

Bidding Parameter: Developers shall compete based on the annualized fixed cost they offer, expressed in rupees per Megawatt (MW) per Month or on Rs/kWh after factoring in the VGF specified in the RfS

Eligible Entities are required to invite bids, either by themselves or through Renewable Energy Implementing Agencies designated by Central Government, following the bidding guidelines issued under section 63 of the Electricity Act, 2003. The BESPA / PPA shall be signed within 9 months from the date of issue of these guidelines, to be eligible for VGF

States / NTPC desirous of availing the VGF are required to submit their proposal to the Central Electricity Authority (CEA) within 60 days from the date of issue of these Guidelines, specifying the implementing agency, location(s) and size of BESS capacity planned for implementation for screening and approval for VGF funding through PSDF

The project may be connected at InSTS or ISTS. The land and InSTS grid connectivity shall be provided by the respective Eligible Entitie/p>

The payment security mechanism shall be as per Electricity (Late Payment Surcharge & Related matters), Rules 2022 as amended from time to time

Bank Guarantee: The Eligible Entities/REIAs shall be required to obtain a Bank Guarantee (BG) of value equal to the VGF to be disbursed, prior to its release to the developer, as specified in the RfS. This BG shall be liable for encashment to recover the VGF amount in the event of non-fulfilment of the scheme conditions specified in the Bidding Documents. The BG for the VGF sanctioned up to COD may be released within one year of COD

Advertisement Space — Coming Soon

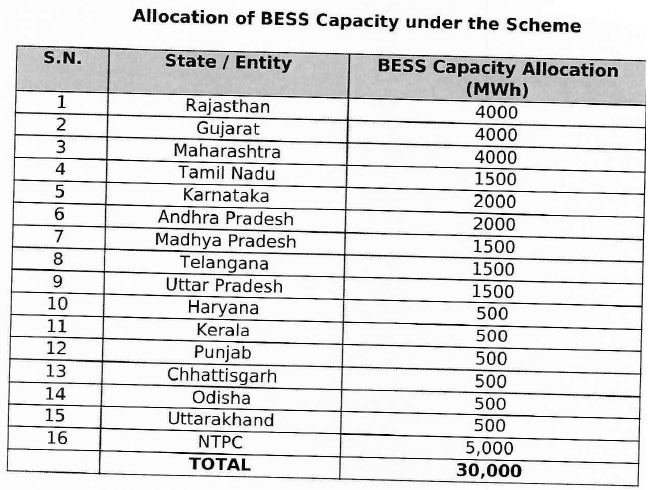

Allocation of BESS Capacity

Advertisement Space — Coming Soon
